Structured preliminary estimates, not generic cost guides

Every output is measured from your documentation with clear measured vs provisional separation. Built for builders who need commercial clarity at the preliminary stage.

What You Receive

Three builder-ready deliverables generated from your plans — a costed report, an editable workbook, and ready-to-send subcontractor packages.

Builder-Ready Estimate Report

Structured for commercial review, not just totals. What is being built, how costs are distributed, and what needs resolving before tender.

15 sections

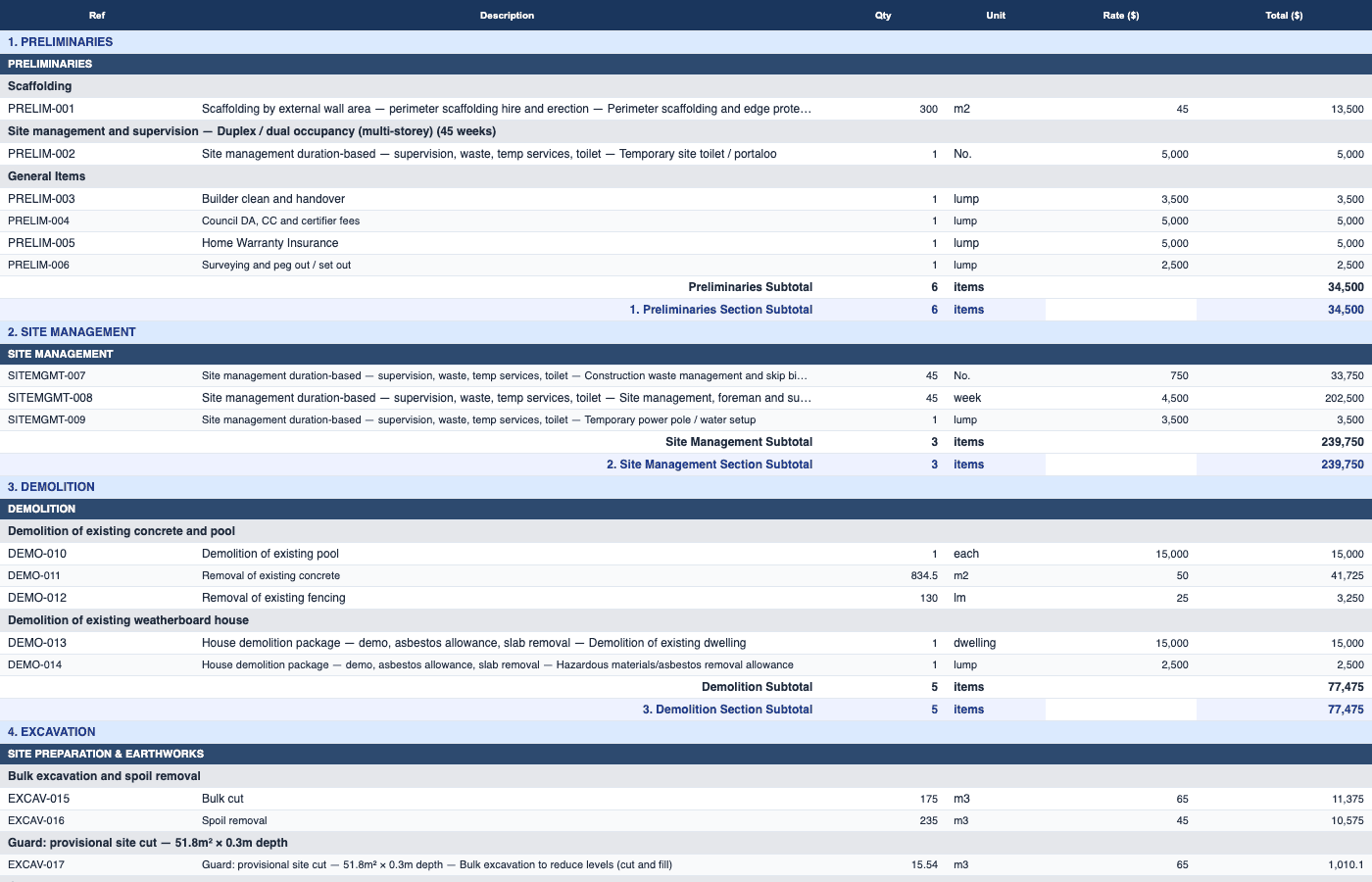

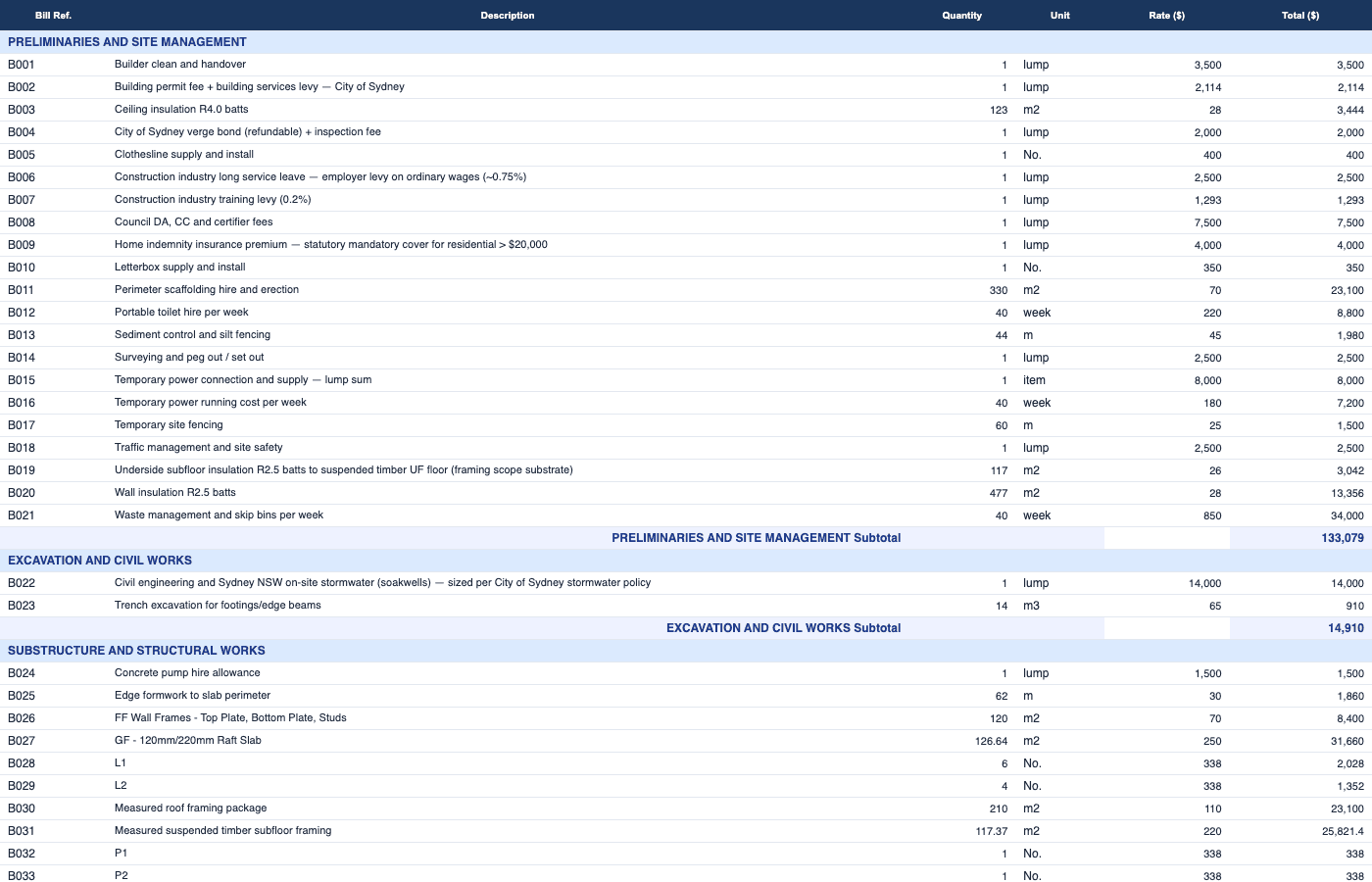

Editable Line-Item Workbook

Every line item is laid out in a builder-friendly workbook so your team can review, update and reuse it.

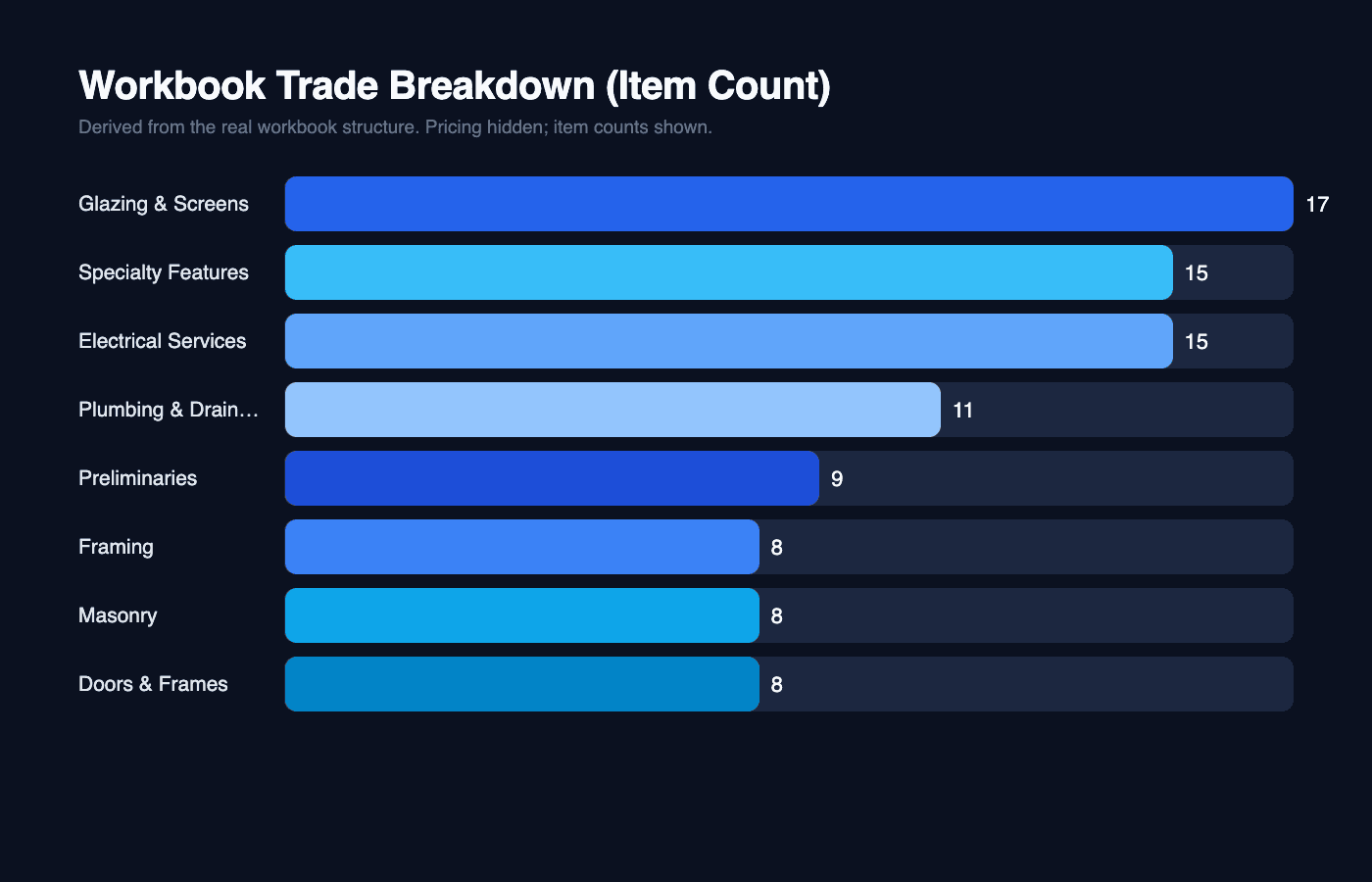

27 sheets

Subcontractor Pricing Packs

Ready-to-send trade packages for competitive pricing. Each trade receives its own sheet with a project-specific scope brief and BOQ table.

11 trade packages

Inside Every Estimate

From plan upload to costed output, every estimate includes market-aligned pricing, risk visibility, and a clear decision register.

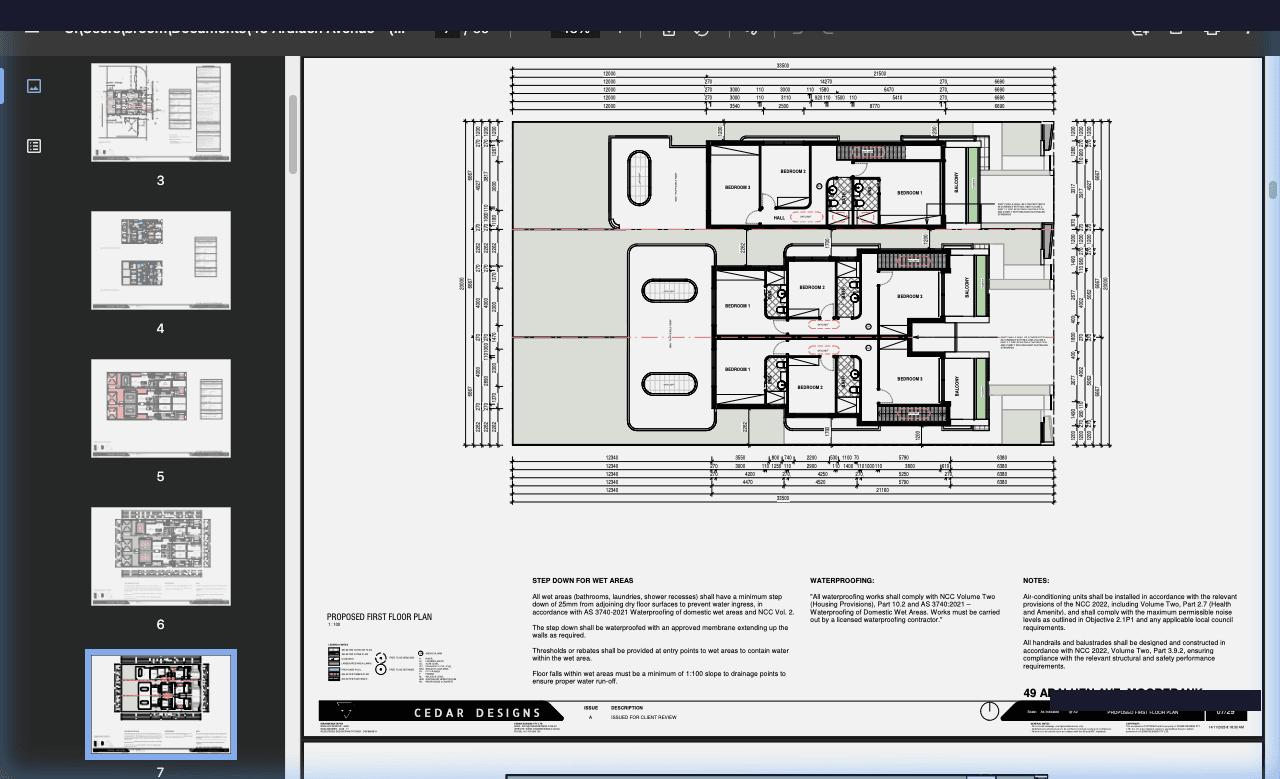

Upload Your Documentation

Same starting requirement as a human estimator: a complete DA-stage plan pack with NatHERS assessment.

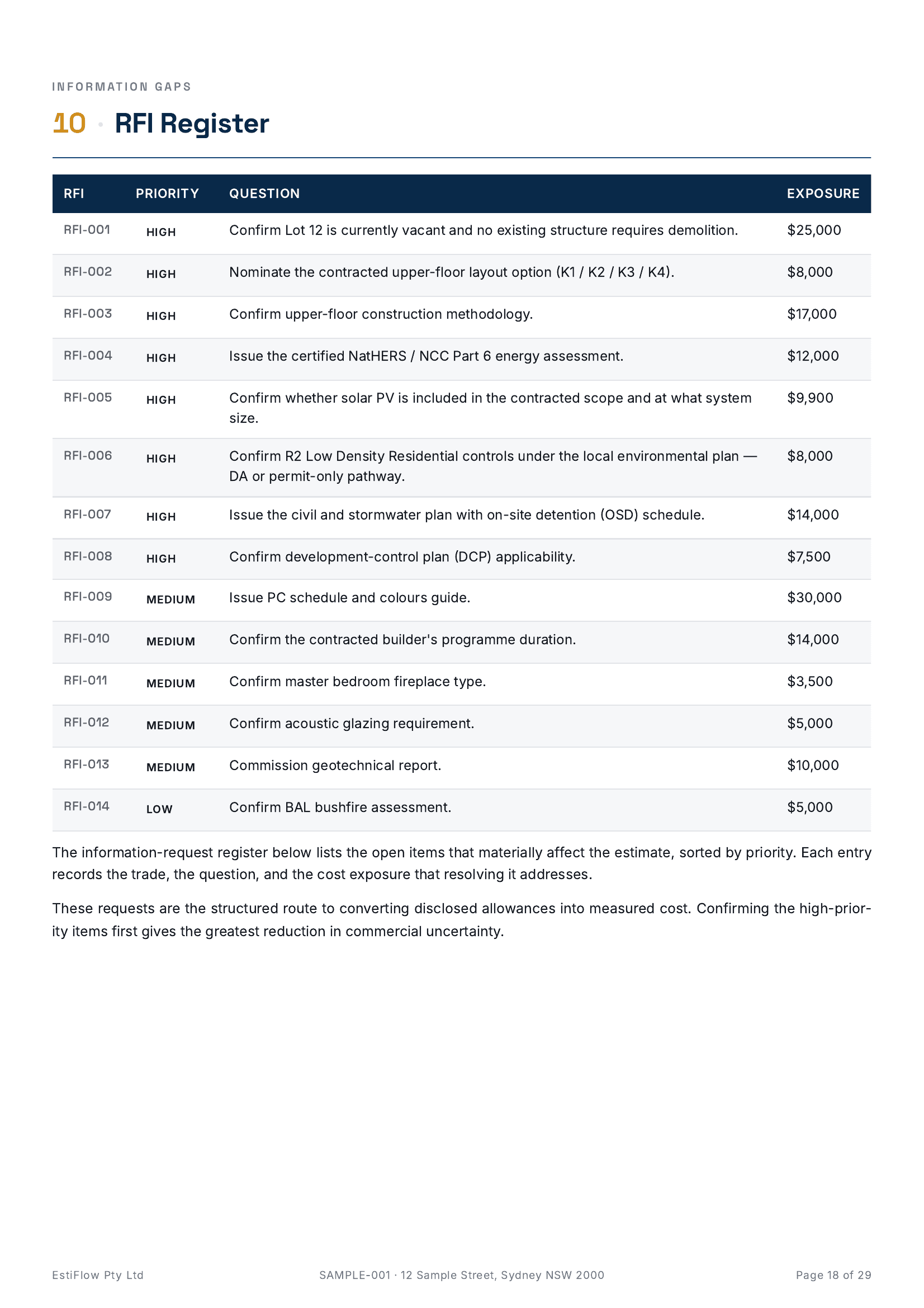

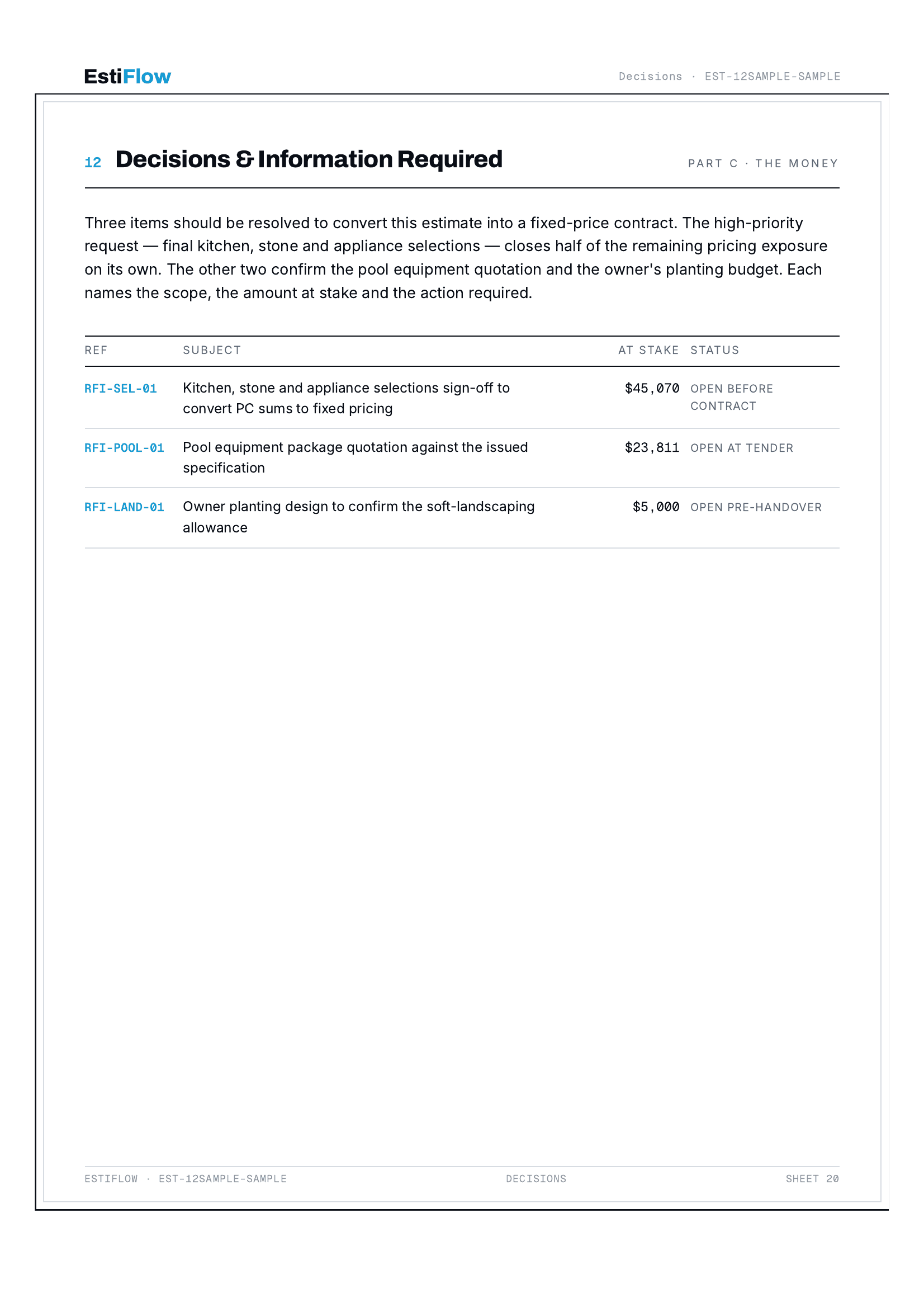

Pre-Tender Decision Register

Every provisional allowance mapped to a specific action, primary lead, and dollar exposure.

Market-Aligned Costing

Costed to current residential market benchmarks so builders are not starting from a blank spreadsheet.

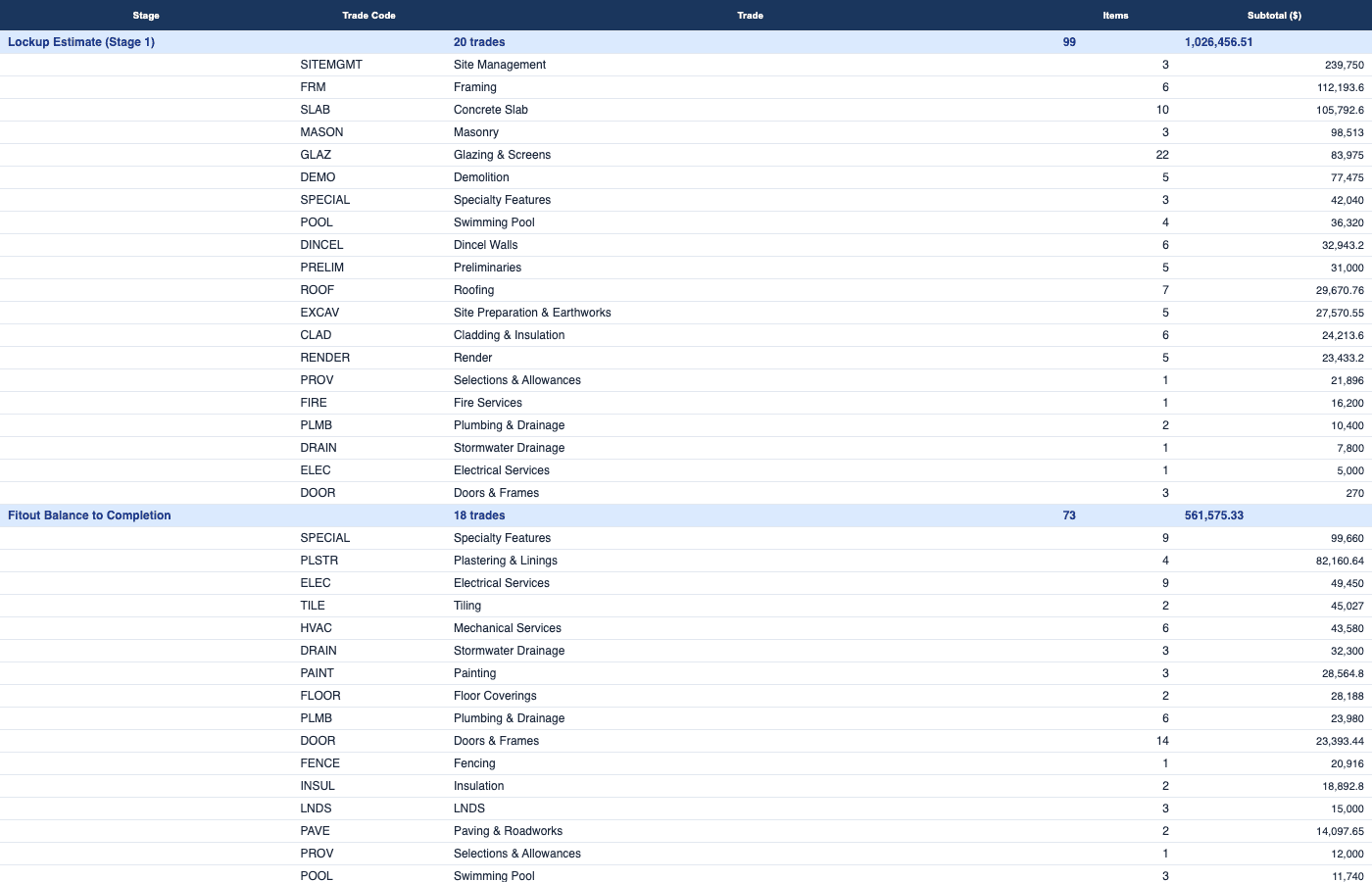

Indicative Construction Programme

Phase-by-phase timeline with lockup milestone, trade durations, and procurement lead times.

Specialty And Premium Items Detected

Lifts, pools, smart home systems, and premium finishes appear as individually priced line items — not generic allowances.

Risks And Gaps Made Visible

Gaps appear as provisional items or RFIs, not hidden assumptions. Risk items are flagged with dollar exposure.

Same Logic As A Human Estimator

More complete documentation produces a more accurate estimate. Fewer provisional sums when the plan pack is stronger.

Your Interactive Portal

Every completed estimate comes with a rich interactive dashboard. Edit rates live, save your preferences, and regenerate deliverables with one click.

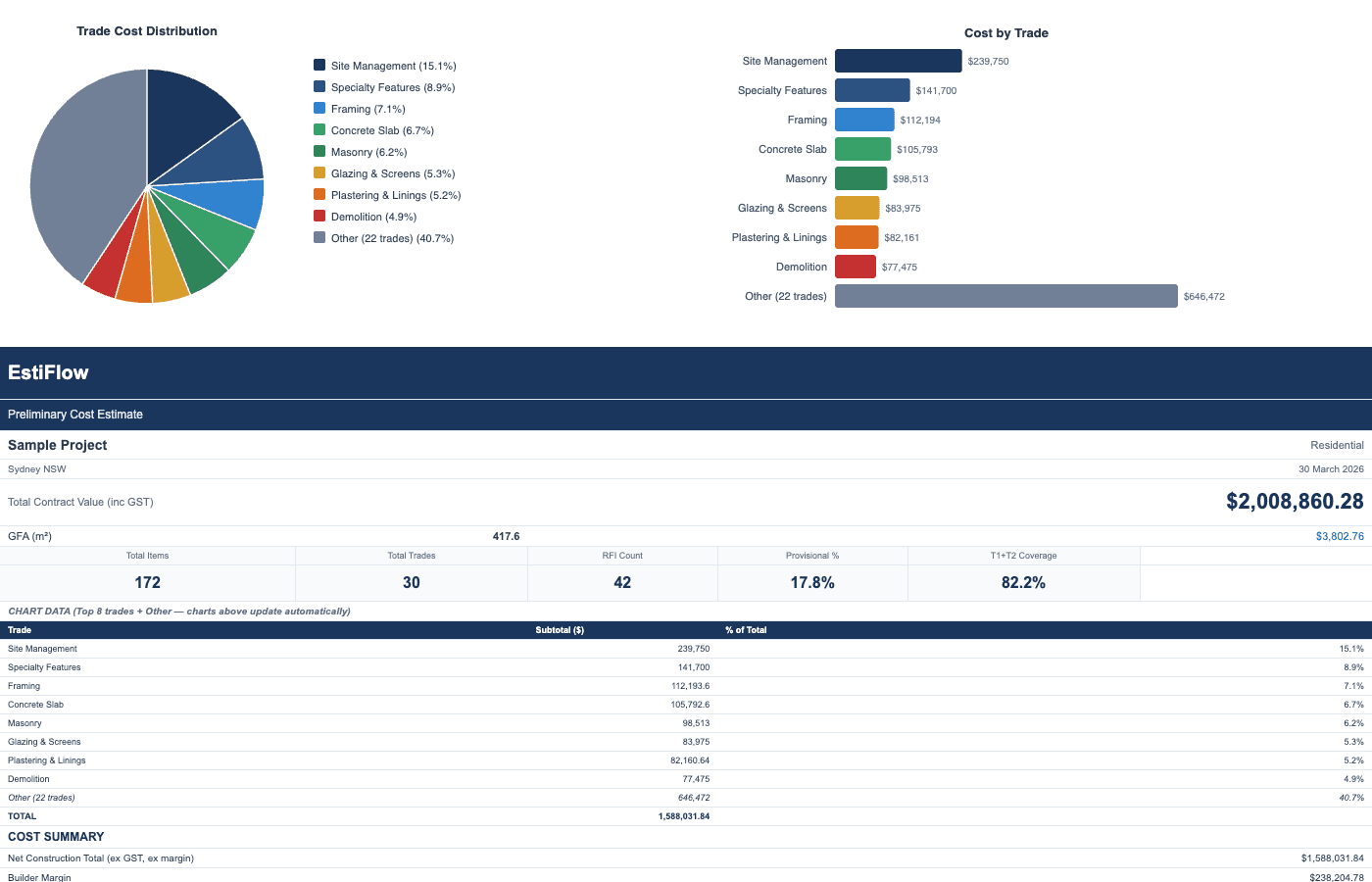

Interactive Estimate Dashboard

Financial snapshot, trade breakdown, measurement coverage — all updating in real time.

Edit Rates And Quantities Live

Click any rate or quantity to edit. Margin and supervision controls built in.

Save Rates And Regenerate Reports

Save rates to your profile. Regenerate all deliverables with one click.

Try The Full Experience

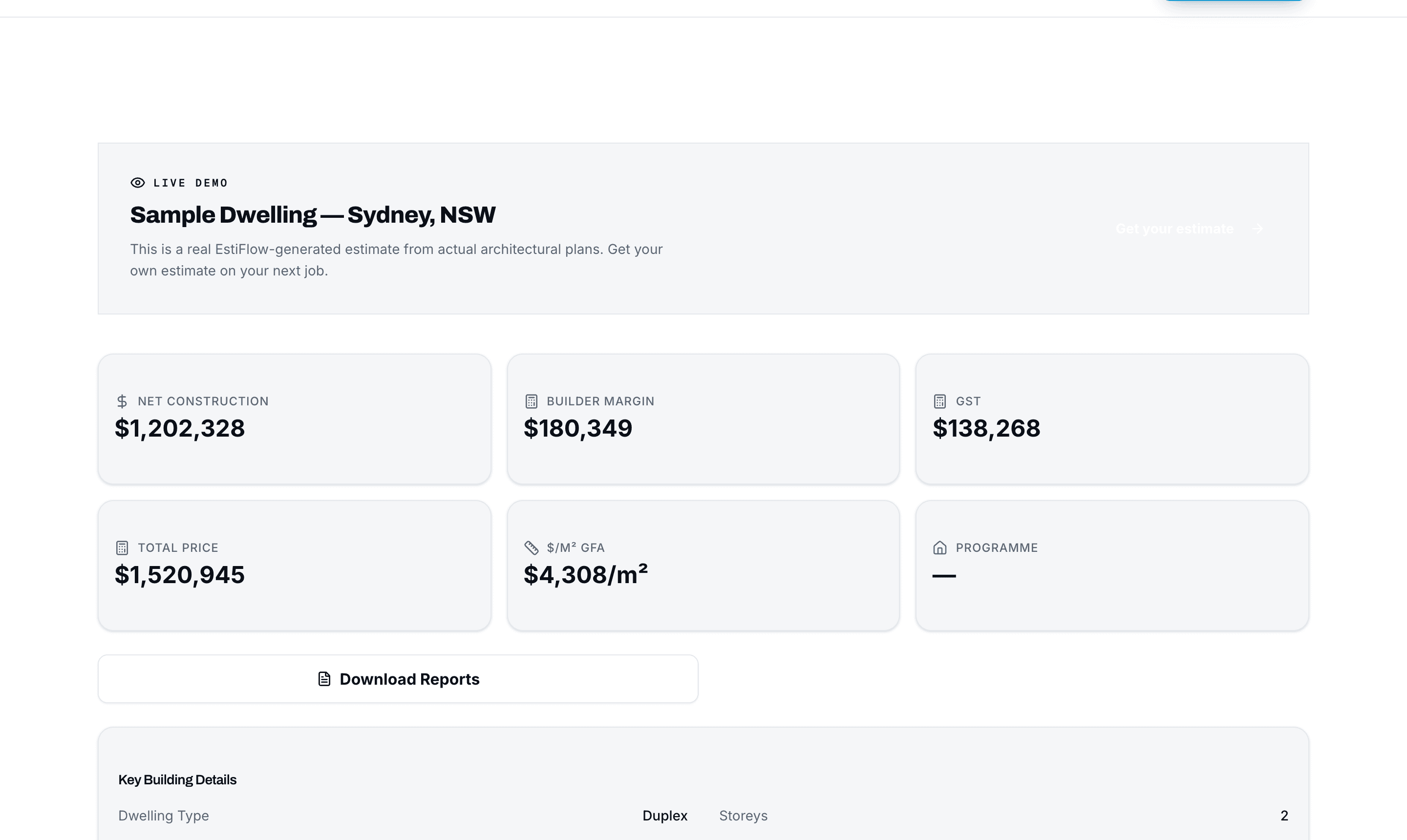

Try the full experience with real data. No signup required.

EstiFlow Dashboard

Net Total

$1,586,146

Contract Price

$2,006,775

$/m² GFA

$3,803/m²

GFA

417.6 m²

Slab
Masonry
Glazing
Site Mgmt

Site Supervision

PM & Foreman weekly costs

Intelligence Built In

Every estimate includes four project-specific intelligence reports generated alongside your deliverables.

Value Engineering Analysis

Top five cost reduction opportunities identified from your project scope, with estimated dollar savings and trade-off analysis.

Construction Risk Register

Project-specific risk and safety register with severity ratings, OHS hazards, control measures, and priority levels.

DA And Council Cost Estimate

Estimated council and certification fees with approval pathway prediction based on your project scope and local council.

Bank Finance Summary

Construction loan valuation stages mapped to your project timeline, ready for a bank finance application.

What You Receive

The public sample is redacted, but it shows the real shape of the output: a builder-ready costed report and an editable workbook.

How We Maintain Accuracy

Estimates are benchmarked against independent professional quantity surveyor reports for residential projects. Rates are sourced from established Australian construction cost references, updated quarterly. The result is a practical estimating pack builders can consume immediately and refine with their own pricing if needed.

Better plan packs produce tighter outputs. Missing information does not get hidden: it appears as provisional content or RFIs so the builder can see where risk still sits.

  • Architectural plans plus energy compliance are required to begin
  • Structural, electrical, hydraulic and landscape docs improve completeness
  • Current market-based costing is included in the delivered output
  • Lockup and fitout staging support progress-claim planning
  • Workbook rates remain editable for builder-specific pricing
  • Provisional sums and RFIs make documentation gaps visible
  • Customer rate profiles allow builders to bring their own market knowledge — your rates override our base card while maintaining the measured quantities from the plans

See it for yourself

Upload your plans and receive a builder-ready costed BOQ workbook and estimate report your team can review right away.
